A charge code defines a type of work you want to estimate, book time against, or both. Every hour logged on a timesheet and every line on an estimate needs a charge code behind it, so getting these set up properly affects everything from resourcing to reporting. This article covers how to create and configure charge codes in File Maintenance, and what each setting on the charge code form controls.
If you're wondering how to set up a charge code in Synergist, this article walks through every section of the form.
Creating or editing a charge code
Charge codes are created and maintained in File Maintenance. Opening an existing charge code, or creating a new one, brings up the same input form, split into a few key sections: Details, Rates, Resource skills and Team skills, and Organisation prices/costs.
Details

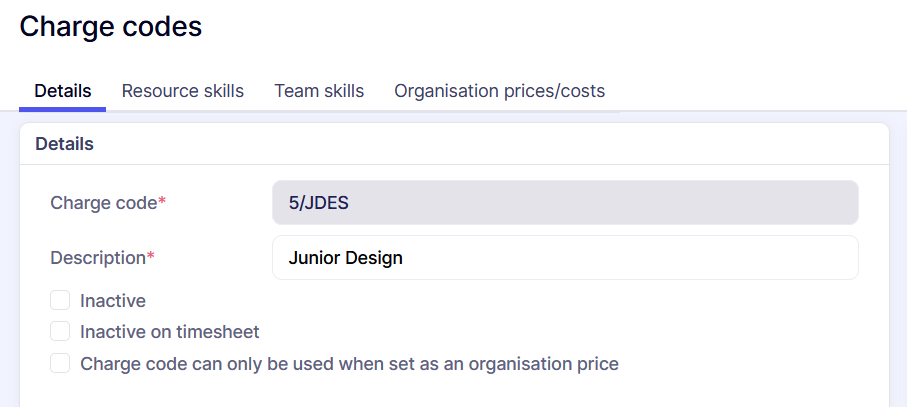

This section covers the basic identity of the charge code and where it can be used.
- Charge code: a mandatory, unique reference. It's generally not shown directly in the user interface, so it doesn't need to be meaningful to end users.
- Description: the label people actually see when choosing a charge code for estimating or timesheets. Make this clear enough that someone can pick the right type of work without guessing.
- Charge code can only be used when set as an organisation price: ticking this restricts the charge code to specific clients. Until the charge code is added to an organisation's rate card, nobody can use it for estimating or timesheet entry on jobs for that client.
Rates and estimating behaviour

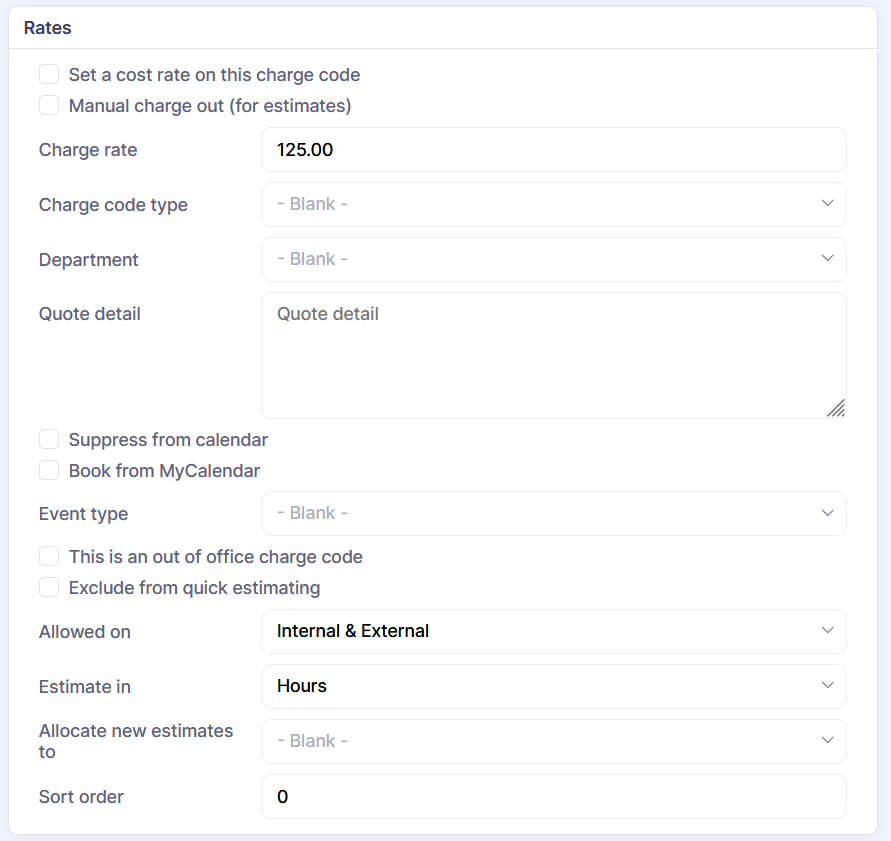

This section sets the financial values behind the charge code, along with a number of options that control how and where it can be used.
- Set a cost rate on this charge code: tick this if you're holding cost rates at charge code level. Cost rates can also sit on other entities in Synergist, each with its own place in the rate hierarchy. See [Link: Understanding cost rate hierarchy] for the full picture.
- Manual charge out for estimates: a special-purpose setting used in Departmental Revenue Analysis, for adjusting charge out values on a phase or transferring charge out amounts between departments. It can only be ticked on charge codes that haven't already been used on an estimate or added to an organisation rate card. See [Link: Departmental Revenue Analysis] for more detail.
- Charge rate: the core value on a charge code. This is the hourly (or optionally daily) rate used to calculate recommended charge out values. Like cost rates, charge rates can also be set at other levels in Synergist. See [Link: Understanding charge rate hierarchy].
- Department: groups charge codes together, either to set a departmental cost rate, simplify re-costing jobs, or support Departmental Revenue Analysis.
- Quote detail: default narrative text added to quote lines whenever this charge code is used on an estimate.
- Suppress from calendar: stops estimates using this charge code from creating calendar bookings.
- Book from MyCalendar: lets users book out-of-office time directly from their calendar using this charge code, linked to an event type such as Holiday or Other. An estimate must already exist on a job for this charge code before the calendar event can be created.
- Out of office: flags a charge code as out-of-office time. Charge codes used for calendar events are typically flagged this way by default, but others can be marked the same if needed.
- Exclude from quick estimating: removes the charge code from the quick estimating option.
- Allowed on: choose between Internal jobs only, External jobs only, or any job. This controls where the charge code shows up during estimating and timesheet entry.
- Estimate in: choose hours or days. If set to days, Synergist uses the company's hours in day setting to work out the value of a time estimate. The charge rate stays hourly and timesheets are still entered in hours, so this only simplifies estimating.
- Allocate new estimates to: sets a default team for new estimates using this charge code, useful for resource planning and calendar bookings.
- Sort order: controls where this charge code appears in lists throughout Synergist.
Resource skills and team skills
These two tabs let you build a matrix of which charge codes apply to which resources or teams. Combined with the company setting Charge code is resource skills restricted, this limits the charge codes a user sees during timesheet entry to only the ones relevant to their skill set.
You can also use this matrix to assign different cost or charge rates to time estimates depending on which resource or team they're allocated to.
Organisation prices/costs
This tab is a read-only view showing which organisation rate card or rate cards this charge code has been added to. It's a quick way to check where a restricted charge code is actually available, without going into each client's rate card individually.
Charge code types
Charge code types let you group and filter charge codes together, so estimating and reporting can work at a category level rather than one charge code at a time. If you regularly need to see or report on a set of related charge codes as a single group, setting up a type is worth doing before you create the charge codes themselves.
Menu path: Settings > File maintenance > Types > Charge code types > New
-
Add a Code, up to 6 alphanumeric characters. Synergist automatically adds 1/ as a prefix, denoting your company number.
Note: don't remove the 1/ prefix. It identifies which company the charge code type belongs to. - Add a Description.
- Click Save and Close.
Using charge codes in an estimate
The whole point of setting up charge codes is to build a detailed, accurate budget for a job. Every time estimate you add to a phase is really three decisions in one: what type of work it is, how much of it you need, and what that work costs and charges out at. Add enough of these lines together and you've built the full budget for the job, ready to turn into a quote for your client.
Find out more about [Link: Creating an estimate].
Changing charge codes and quantities to hit a target
Once a first-pass estimate is built, you'll often need to bring it in line with a target value, whether that's a recommended charge out figure, a profit margin, or a budget the client has given you. There are two levers for this:
- Adjust the quantity: reduce the hours or days allocated to a line, for example cutting back the amount of senior designer time.
- Swap the charge code: change the type of work on a line entirely, for example moving hours from senior designer to junior designer.
Either change updates the job's total estimated cost and total estimated recommended charge immediately, so you can see the effect of your adjustment straightaway rather than waiting for a recalculation.
Fine-tuning copied and template estimates
This kind of adjustment matters most when you're copying an estimate from a previous job or a template. A copied estimate gives you a fast starting point, but it won't match the brief for this job exactly. Reviewing and adjusting the charge codes and quantities line by line is a normal part of turning a generic estimate into one that fits the job in front of you.
Find out more about [Link: Copying an estimate from a template or previous job].
Tips
- Keep descriptions short and specific. A long list of similar-sounding charge codes slows everyone down at timesheet entry.
- Use Allowed on to keep internal-only charge codes off external job estimates, rather than relying on people to choose correctly.
- Set Sort order deliberately for your most-used charge codes, so they sit at the top of the list instead of getting buried alphabetically.
- When fine-tuning a copied estimate, check the charge codes before the quantities. The wrong type of work at the right hours still gives you the wrong budget.
- Decide on organisation restrictions and manual charge out settings before a charge code goes live. Both lock once the charge code is in use.
